What are 15 Costly Aluminum Formwork Mistakes

Introduction

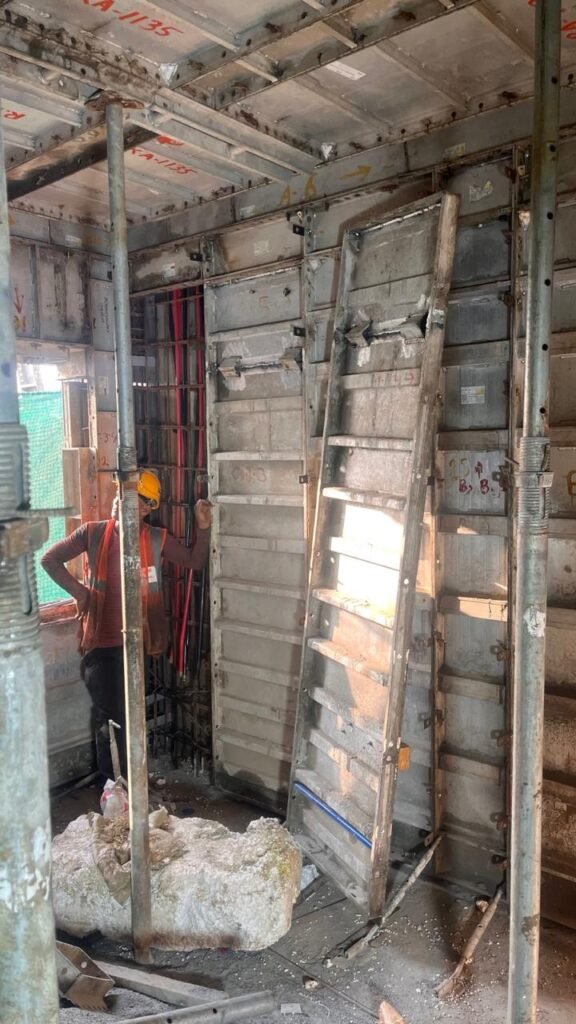

Aluminum form work systems, commonly known as Mivan or Aluform systems, have revolutionized modern construction by enabling faster construction cycles, improved dimensional accuracy, and superior concrete finishes. However, the success of any aluminum form work project depends heavily on how the form work is handled, inspected, and maintained after each concrete pour.

The first pour is particularly critical. It provides valuable insights into the performance of the form work system and reveals defects that can affect future pours if left unattended. Many construction projects experience recurring quality issues because damaged panels, misaligned components, and poor maintenance practices are ignored after the first cycle.

This article discusses the most common aluminum form work problems observed after the first concrete pour and practical methods to prevent them.

Why the First Pour Matters

The first concrete pour acts as a performance test for the entire form work system. During stripping and inspection, engineers can identify:

  • Panel deformation
  • Joint leakages
  • Alignment issues
  • Surface finish defects
  • Accessory damage
  • Improper erection practices

Addressing these issues immediately can significantly improve quality and productivity in subsequent cycles.

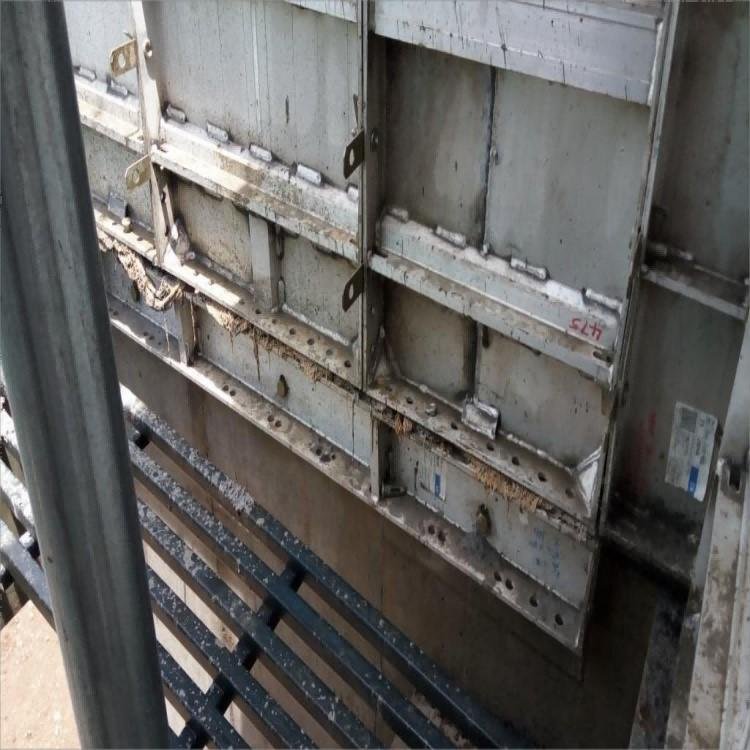

1. Concrete Residue Sticking to Form work Panels

One of the most common issues after the first pour is hardened concrete adhering to the panel surfaces.

Causes

  • Insufficient release agent application
  • Delayed cleaning after stripping
  • Poor-quality shuttering oil

Impact

  • Rough concrete finish
  • Increased stripping effort
  • Reduced panel lifespan

How to Avoid It

  • Apply a uniform coat of approved release agent before each pour.
  • Clean panels immediately after dismantling.
  • Use plastic scrapers instead of metal tools that can damage panel surfaces.
ALU FORM

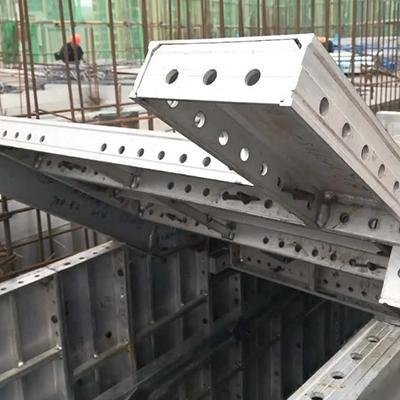

2. Bent or Distorted Panels

Aluminum panels are lightweight but can become damaged due to improper handling.

Causes

  • Dropping panels during dismantling
  • Improper stacking
  • Excessive impact from tools

Impact

  • Uneven wall surfaces
  • Misalignment during assembly
  • Concrete leakage at joints

How to Avoid It

  • Train workers on proper dismantling procedures.
  • Store panels on level timber supports.
  • Inspect flatness before every reuse.
ALU FORM

3. Concrete Leakage Through Panel Joints

Leakage marks often become visible after the first pour.

Causes

  • Loose wedges and pins
  • Damaged panel edges
  • Improper alignment

Impact

  • Honeycombing
  • Concrete fins
  • Additional repair work

How to Avoid It

  • Verify all wedge connections before pouring.
  • Replace damaged accessories immediately.
  • Conduct pre-pour inspections using a checklist.
ALU FORM

4. Damaged Pins and Wedges

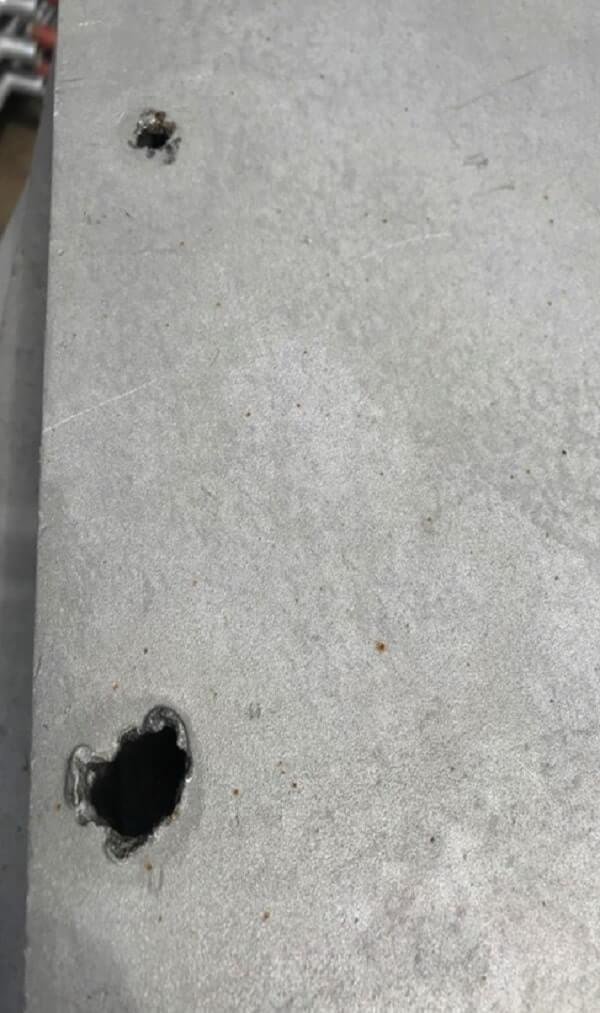

Pins and wedges are critical components that maintain form work stability.

Causes

  • Excessive hammering
  • Poor storage practices
  • Repeated reuse without inspection

Impact

  • Loose connections
  • Form work movement during pouring
  • Safety concerns

How to Avoid It

  • Use correct installation techniques.
  • Replace worn-out components.
  • Maintain adequate stock of spare accessories.
ALU FORM

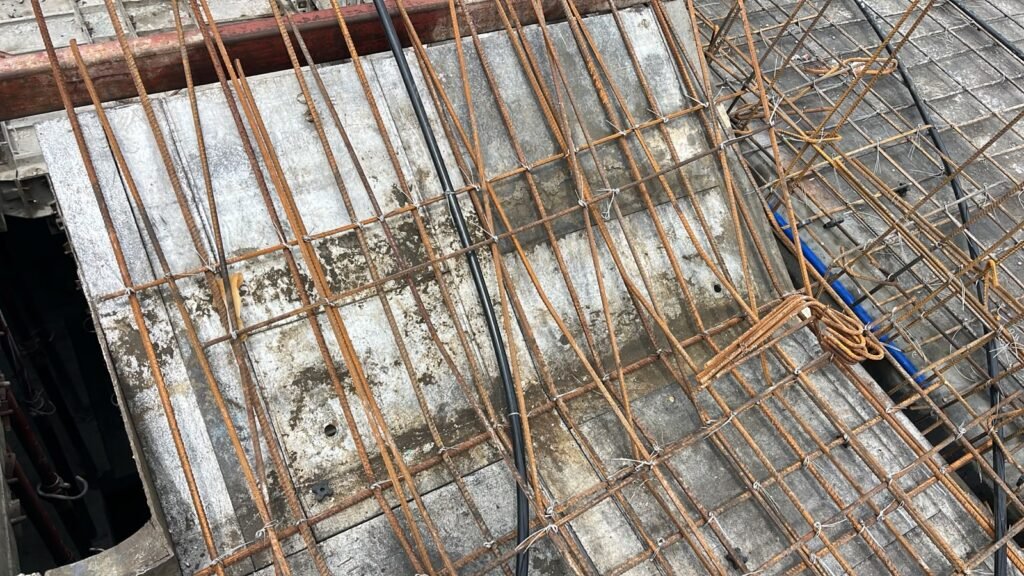

5. Misalignment of Walls and Columns

Verticality issues often originate during the first cycle.

Causes

  • Improper plumbing
  • Inadequate bracing
  • Poor survey control

Impact

  • Dimensional deviations
  • Rework and corrective measures
  • Reduced structural aesthetics

How to Avoid It

  • Check alignment before concreting.
  • Use laser levels or total stations.
  • Verify plumbness at multiple locations.
ALU FORM

6. Damaged Corner Panels

Corners are highly susceptible to damage during stripping.

Causes

  • Rough dismantling methods
  • Improper lifting practices

Impact

  • Irregular building corners
  • Surface defects
  • Additional finishing costs

How to Avoid It

  • Remove corner panels carefully.
  • Provide training to shuttering teams.
  • Inspect corner components after every cycle.
ALU FORM

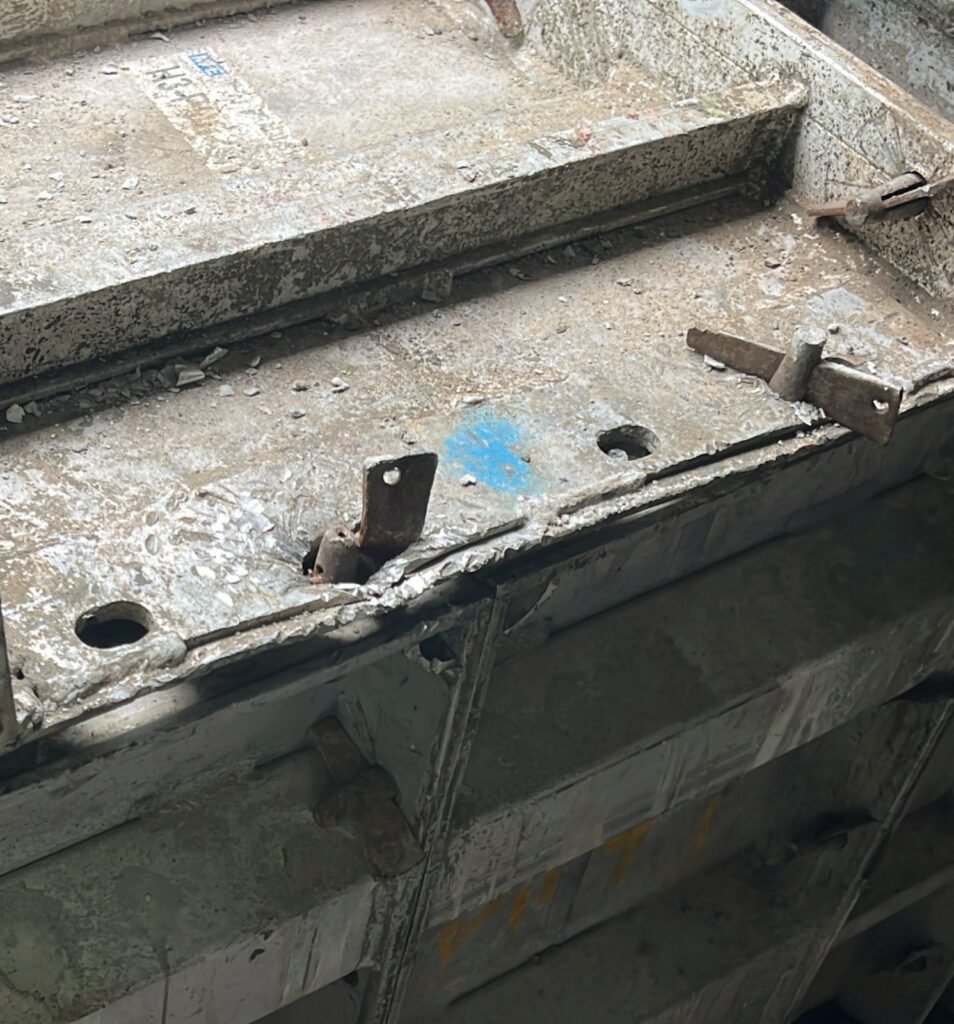

7. Kicker Alignment Issues

Kickers establish the position of subsequent walls.

Causes

  • Incorrect installation
  • Movement during concreting

Impact

  • Wall offsets
  • Alignment discrepancies
  • Rework in upper floors

How to Avoid It

  • Verify kicker dimensions before panel erection.
  • Monitor movement during concrete placement.
  • Conduct post-pour alignment checks.
ALU FORM

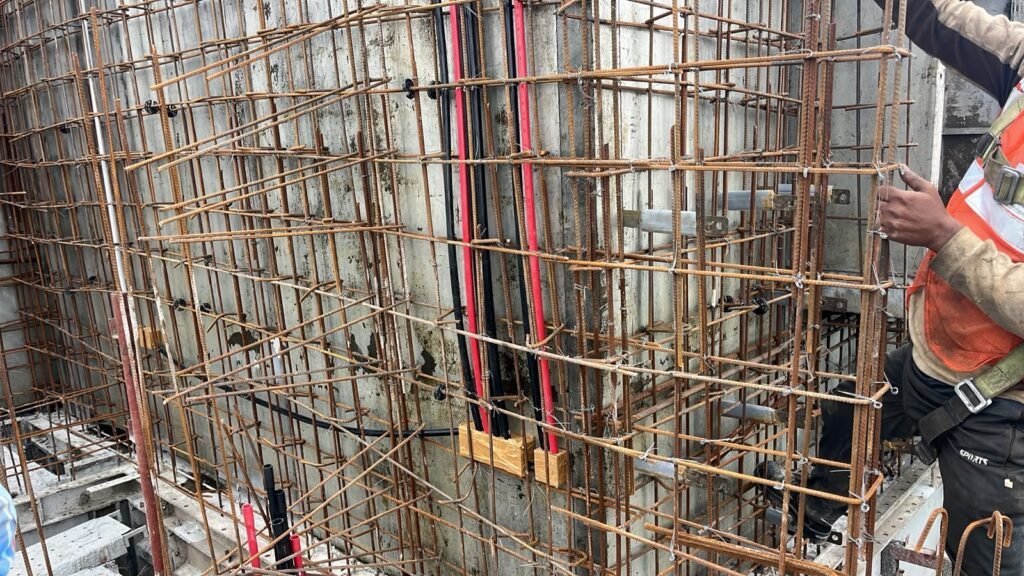

8. Damaged Slab and Deck Panels

Deck panels carry significant loads during construction.

Causes

  • Material storage on form work
  • Overloading by workers and equipment

Impact

  • Uneven slab soffits
  • Deflection issues
  • Reduced panel life

How to Avoid It

  • Follow load limitations.
  • Avoid storing construction materials on deck panels.
  • Inspect panels before reuse.

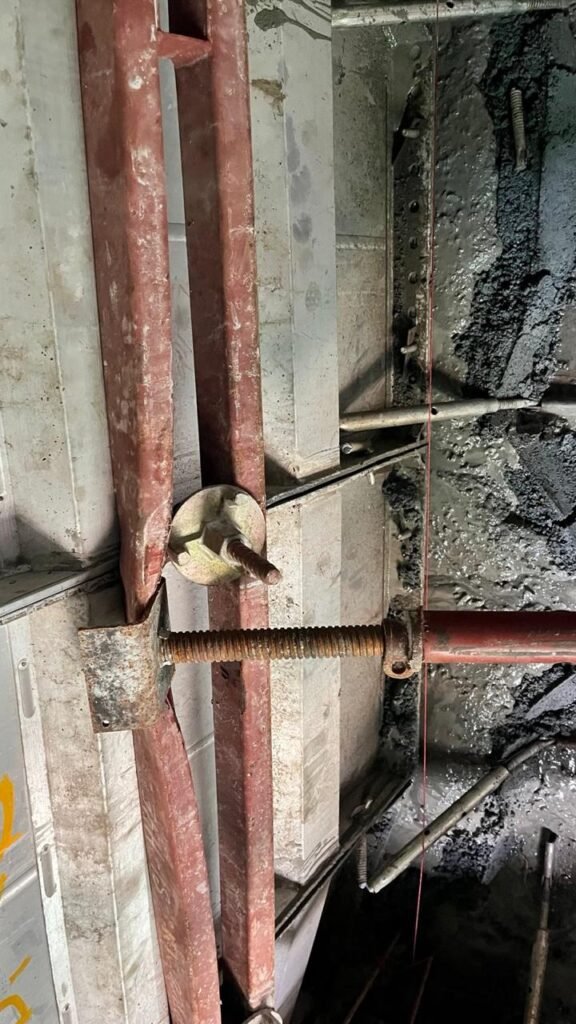

9. Bent Props and Support Systems

Supporting systems must remain structurally sound throughout the cycle.

Causes

  • Overloading
  • Improper adjustment
  • Impact damage

Impact

  • Slab settlement
  • Safety risks
  • Structural defects

How to Avoid It

  • Conduct routine inspections.
  • Remove damaged props immediately.
  • Verify load capacities before installation.
ALU FORM

10. Poor Cleaning and Maintenance Practices

Many form work issues result from inadequate maintenance.

Causes

  • Lack of maintenance procedures
  • Insufficient supervision
  • Time pressure

Impact

  • Reduced productivity
  • Increased repair costs
  • Poor concrete quality

How to Avoid It

Implement a standardized maintenance process that includes:

  • Cleaning
  • Inspection
  • Repair
  • Storage
  • Documentation
ALU FORM

Recommended Post-Pour Inspection Checklist

After every pour, site engineers should inspect:

✓ Panel flatness

✓ Panel cleanliness

✓ Pins and wedges

✓ Wall ties

✓ Corner panels

✓ Deck panels

✓ Props and supports

✓ Alignment accessories

✓ Joint conditions

✓ Identification markings

Document all observations and repair damaged components before the next cycle.

Best Practices for Long-Term Form work Performance

To maximize the lifespan and performance of aluminum form work systems:

  1. Conduct pre-pour and post-pour inspections.
  2. Train workers on proper handling techniques.
  3. Maintain a dedicated storage area.
  4. Replace damaged accessories immediately.
  5. Use approved release agents.
  6. Monitor alignment throughout the construction process.
  7. Maintain detailed inspection records.

Conclusion

The first concrete pour provides a valuable opportunity to identify and correct aluminum form work defects before they become recurring problems. Issues such as concrete residue, panel deformation, leakage, alignment errors, and damaged accessories can significantly impact project quality, productivity, and cost if ignored.

By implementing a structured inspection and maintenance program, construction teams can extend form work life, improve concrete quality, reduce rework, and achieve faster construction cycles. For QA/QC engineers, site engineers, and project managers, proactive post-pour inspections are not merely a quality requirement—they are a critical investment in project success.

A well-maintained aluminum form work system delivers consistent results, minimizes defects, and supports the high-speed construction standards expected in modern building projects.
